A subfloor space showing brick piers and dwarf walls carrying timber bearers and floor joists
Court of Appeal
Case file · Supreme Court of Victoria, Court of Appeal

“Tradies love cash”: the builder who had to pay $50,000 back

A builder quoted $2,188,482 for a three-storey house. The owners could not afford it. He offered to do it for $1.71 million, on one condition: $110,000 of it in cash. They agreed, and paid $50,000 of that cash before the job fell apart. On 4 June 2026 the Court of Appeal held the cash agreement void, ordered the builder to repay every dollar of it, refused him leave to appeal, and left his claim for $365,746.78 of unpaid work valued at nil. The reason it came to nothing is the part every homeowner should read: defective brickwork low in the build meant the stages above it were never complete.

Case: A.M.O. Rifat Holdings Pty Ltd v Dib
Citation: [2026] VSCA 124
Judgment: 4 June 2026
Bench: Niall CJ, Beach and Donaghue JJA

01What the Court of Appeal decided

The disposition, before anything else.

$110,000
The cash side agreement
Held void
$50,000
Ordered repaid
Forthwith, with interest
$365,746
Claimed for unpaid work
Valued at nil
A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, PART E
“For the above reasons, with respect to the builder’s application for leave to appeal, we would refuse leave to appeal on both grounds. With respect to the application for leave to cross-appeal, we conclude that the Court has no jurisdiction with respect to proposed ground 1. We would grant leave to appeal on ground 2, allow the cross-appeal on ground 2, and order that the builder pay to the owners $50,000 forthwith.”
Niall CJ, Beach and Donaghue JJA. Heard 25 March 2026, judgment 4 June 2026, on appeal from the President of VCAT. The builder lost on everything he asked for. The owners won the money and lost one ground, and section 08 explains why that loss is worth understanding.

The builder had sued in the Tribunal for $729,112.03 in damages, comprising unpaid progress payments, variations, delay claims and interest, with the quantum meruit claim as his alternative. He recovered none of it, and left owing $50,000.

The case has been written up several times since June, and every summary we have seen leads on quantum meruit, which is the lawyers' interest. That is not the part a homeowner needs. The part a homeowner needs is why the builder's claim was worth nothing, and it has nothing to do with restitution doctrine. It is about brickwork.

02The deal, and the sentence that undid it

Two contracts, signed the same day.

The builder had quoted $2,188,482 to build a three-storey house. The owners could not afford it, so the scope came down. At a meeting in early April 2017 the builder's sole director made an offer, and the Court records his words:

A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, PART A
“he would ‘do it for $1.71, but I want $110 in cash. Tradies love cash and it’s cheaper to use cash when you hire them’.”
Quoted in the reasons from the findings below. The price reduction was also recorded in an email from the builder's project manager later the same day, so this was not a misremembered conversation.

On 5 May 2017 the parties signed a Master Builders Association HC6 contract for a price of $1,600,000. On the same day they signed a second document, which the Court calls the side agreement, recording a “Total Construction Cost” of $1,710,000. The extra $110,000 was to be paid in cash instalments, triggered by the very same milestones as the contract payments.

In the contract itself the parties agreed that the progress payment stages fixed by section 40 of the Domestic Building Contracts Act would not apply, which the Act permits, and adopted their own schedule instead. It was set out as six stages:

Stage
%
Amount
Deposit
5%
$80,000
Ground plumbing
10%
$160,000
Base stage
10%
$160,000
Frame stage, ground floor
10%
$160,000
Frame stage, first floor
10%
$160,000
Frame stage, second floor
10%
$160,000

Note how the contract defined the two stages that end up mattering. Base stage, for a home with a suspended concrete slab floor, meant when the concrete footings are poured. Frame stage meant when the home's frame is completed and approved by the building surveyor. Both are completion tests, and completion is not the same thing as a truck having left the site.

The work started in July 2017. Ground plumbing and base stage were completed and paid. The ground floor frame was finished around 10 October 2017 and the owners' financier paid the $160,000. Alongside all this the owners paid cash under the side agreement: $30,000 on 1 August, $10,000 on 6 September, and a third payment on 31 October. Fifty thousand dollars in cash, before relations soured at a meeting near the site in January 2018.

03Why a cash deal on the side is void

And why opting out of the standard stages does not make it legal.

The builder's argument was that because the parties had lawfully opted out of the standard payment stages, they were free to arrange payments however they liked. The Court disagreed, and the reasoning is worth following because the same argument gets made on sites every week in less formal language.

Domestic Building Contracts Act 1995 (Vic)S 40(2), AS QUOTED IN THE JUDGMENT
a builder must not “demand or recover or retain under a major domestic building contract … more than the percentage of the contract price listed in column 2 at the completion of the stage referred to in column 3”
Section 40(4) allows parties to agree that s 40(2) does not apply, but only if they do it in the manner set out in the regulations, using Form 2. The Court described those requirements as “plainly cumulative”.

Opting out swaps one payment schedule for another. It does not switch off the protection:

A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, PART C
“an alternative payment regime under s 40(4) substitutes for the table in s 40(2), but ‘does not open the door to collateral agreements and additional progress payment tables that are clearly outside what is contemplated by the [Act]’.”
The side agreement's payment schedule was not in a Form 2 table, so it did not come within the exception.

The builder then argued the side agreement was not a domestic building contract at all, merely a collateral one. The Court treated that as beside the point:

A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, PART C
“The important question is whether it was a ‘domestic building contract’, which is defined in s 3(1) to mean ‘a contract to carry out, or to arrange or manage the carrying out of, domestic building work other than a contract between a builder and a sub-contractor’.”
It was one, because it provided for payment for the construction of a home. As the owners put it, it was “an agreement for part of the contract price to be paid in cash”.
A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, PART C
“Section 40(2) therefore expressly prohibited the builder from ‘demanding, recovering or retaining’ funds under the side agreement. The side agreement was therefore void by reason of s 132(1) of the Act, with the consequence that the builder had no contractual entitlement to the balance of the amounts specified in that agreement.”
Void. Not merely unenforceable in part, and not merely unwise.

Nor could the builder route around it by claiming the value of the work instead. Applying an earlier Court of Appeal decision, Stephens v Cameron:

Stephens v Cameron (2021) 65 VR 117QUOTED AT PART C
“for the applicant to pursue a quantum meruit claim would be to seek the very payment for work done which the statute forbids. The coherence of the law and the need to avoid stultifying the statutory purpose of s 40(2) mean that this could not be permitted”
The prohibition cannot be dodged by relabelling the claim.

There was one escape route available and the builder did not take it. The stated purpose of the cash was to pay subcontractors, and the Court noted that a builder who had actually disbursed the money that way might have had a defence of change of position. But no evidence of any such disbursement was led:

A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, PART C
“the builder was aware that the owners sought to recover the $50,000 already paid under the side agreement, yet the builder did not lead any evidence that it had disbursed those funds to subcontractors. Having chosen not to advance such a defence, it is bound by the conduct of its case.”
The order was that the builder repay the $50,000 with interest.

04A defect at base stage made every frame stage incomplete

This is the finding that decided the money, and no summary of this case leads with it.

A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, PART B
“The President held, in reasoning that is not challenged, that substantial defects in the structural brick columns that formed part of the base stage meant that the base stage was incomplete. It followed from that conclusion that ‘each of the frame stages was also incomplete’. On that basis, the President held that the builder did not have a contractual entitlement to the progress payments for either the base or frame stages (although the builder had in fact been paid the progress payments for the base and ground floor frame stages).”
Citing Cardona v Brown (2012) 35 VR 538. Read the parenthesis again: the builder had already been paid for two of the stages he was not entitled to be paid for.

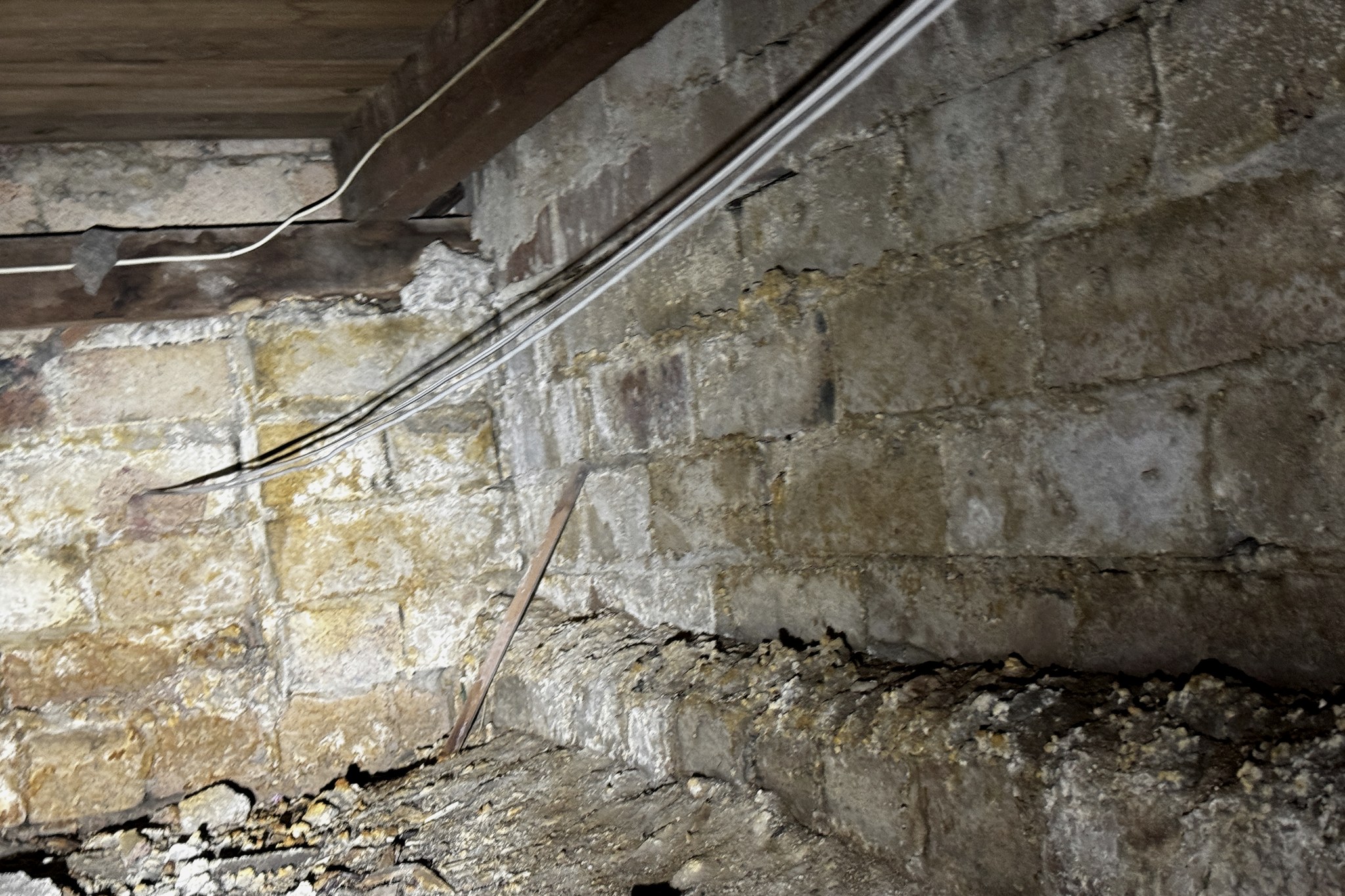

Deteriorated structural brickwork in a subfloor with a timber bearer bearing directly on it
Structural masonry carrying a bearer. Whatever is built above a wall like this inherits its condition. Site Inspections photograph from our own files, illustrative of the type of work described. It is not a photograph of the property in this case.

Follow the logic, because it is simple and it is the whole game. A stage payment is earned when the stage is complete. The contract defined base stage by reference to the footings and frame stage by reference to the frame being finished and approved. If the structural brick columns forming part of the base stage are substantially defective, the base stage is not complete. And a frame cannot be complete when it is sitting on a base stage that is not.

So one defect, low in the build, travelled upwards through every stage above it and removed the entitlement to be paid for any of them. Not reduced. Removed.

We spend a good part of our working week at base and frame stage, and the reason is exactly this. A defect found at that point is cheap to fix, visible, and still attached to a payment the owner has not made yet. The same defect found after handover is expensive, hidden behind finishes, and attached to money that has already gone.

05What that finding did to the builder's money

Three consequences, in order.

Consequence
Why
1
No entitlement to the unpaid frame stage claims
Those stages were not complete, so the contractual trigger for payment never happened
2
Already paid for two stages he was not entitled to
Base and ground floor frame had both been paid, one of them by the owners' financier
3
The fallback claim collapsed too
The quantum meruit claim was the alternative route to being paid, and section 06 is what happened to it

It is worth being precise about what this case does and does not decide. It does not say a homeowner can withhold a progress payment because they are unhappy. Whether a stage is complete is a question of fact, decided on evidence, and here it was decided by the President of VCAT after a trial and left undisturbed on appeal. What the case establishes is the principle: completion is a real test with real consequences, and a defect in the work of one stage can mean the stages built on top of it were never complete either.

06A claim for $365,746.78, valued at nil

The fallback, and why the evidence could not carry it.

Having lost the contractual route, the builder claimed $365,746.78 as the reasonable value of the work performed to termination. The way that figure was built is the reason it failed. It was particularised only days before trial, as a table of every invoice issued on the project, which the Court observed gave “no information as to the stage of the project that the invoice concerned, or whether the builder had been paid with respect to that work”. The table simply totalled the work, added 5% for preliminaries and 15% margin, and subtracted what had been paid.

The President declined to value the claim that way, and his third reason is the one that connects back to section 04:

A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, PART B, QUOTING THE REASONS BELOW
“the nature and extent of the defects in the base stage and each of the frame stages … undermines any presumption that the invoiced amounts represent the value to the owners of the work.”
Defective work is not worth what it was invoiced at. That is not a punishment, it is a valuation.

The conclusion was that “the benefit to the owners of the works undertaken by the builder and not paid for at the time of contract termination is nil”.

On appeal the builder argued the stage amounts in the contract should have been used to value the work. The Court's catchwords answer it in a line that is worth keeping:

A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, CATCHWORDS
“Amount of contractual entitlement to payment on completion of a stage is a ‘cap’ on amount recoverable, not a substitute for assessing the value of work done”. Then, separately: “Quantum meruit different to contractual damages”. And: “Builder’s evidence incapable of establishing value of the work done for which there was no contractual entitlement to payment”.
The three catchword phrases are quoted separately so the Court's own punctuation is not altered. The stage price is a ceiling, not a measure. The builder still had to prove what the work was actually worth, and did not. The Court also declined to send the matter back so he could run the case again on different evidence.

07The owners got an inspector in. He was right.

This is the part of the judgment we would most like every homeowner to read, and it is not in any summary of this case we have seen.

Relations had soured at a café near the site on 29 January 2018, where the owners accused the builder of fabricating and overcharging for excavation variation costs, which the builder denied. On 13 March the builder invoiced $160,000 for the first floor frame stage. What the owners did next is the whole point of this section.

On 17 April 2018 Mrs Dib emailed the builder and told him to stop:

A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, PART A
“We’re requesting you not to proceed with any further work on our site as of today until further notice”
Attached to that email was a preliminary report from an inspector the owners had arranged to attend the site. The judgment records that the report “alleged the first-floor frame stage had not been completed”.

The builder's response tells you what that report was worth:

A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, PART A
“In response to Mr Ryan’s report, the builder withdrew the first-floor frame stage payment claim and stated that it remained ready and willing to perform the works and to comply with its obligations under the contract.”
An independent inspection report, obtained by the owners, caused a $160,000 progress claim to be withdrawn. Not disputed, not negotiated. Withdrawn.

It did not stop there. On 13 July 2018 the registered building surveyor attended the site and directed the builder to fix work in respect of the frame stages. That is the free power we wrote about separately: a Direction to Fix, which costs you nothing. The surveyor returned on 27 July and approved the frame stages, and the builder then reissued its claims, $160,000 and $154,800 for the first and second floor frames, plus two further $10,000 cash claims under the side agreement. The owners did not pay them.

Then, on 8 August 2018, the builder issued a notice of intention to terminate. It set out four categories of breach. The second was refusing to comply with the contract, and the particulars given for that category included this:

A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, PART D
the owners had “invalidly withheld payments on the basis that it proposes that an expert report to be obtained” in respect of the frame stages
Quoted from the builder's own notice as reproduced in the judgment. Getting the work independently examined was put in writing as a particular of the owners' breach.

We want to be careful here, because it would be easy to overstate it. The notice listed four categories and the expert report point is one particular within one of them. The judgment does not find that asking for a report caused the termination, and neither do we.

But set the sequence out and it speaks for itself. The owners engaged an inspector. He reported that the first floor frame stage was not complete. The builder withdrew that claim. The building surveyor then directed the builder to fix the frame work. The builder terminated, and sued for $729,112.03 in damages, or $365,746.78 on a quantum meruit as the alternative. And six years later the President of VCAT found substantial defects in the structural brick columns at base stage, with the consequence that the base stage and every frame stage above it were incomplete and the builder had never been entitled to be paid for any of them.

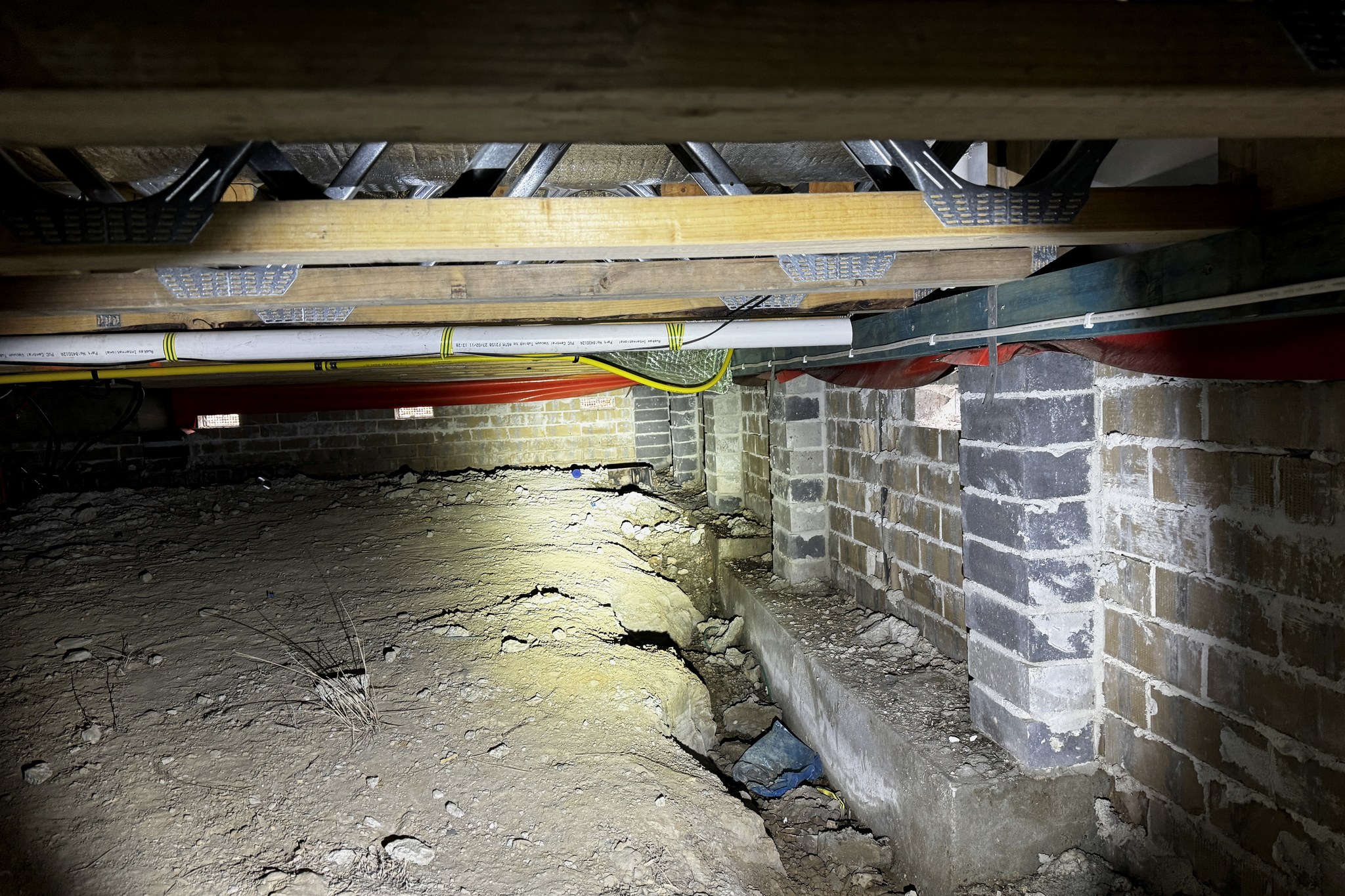

A subfloor space showing brick piers and dwarf walls carrying timber bearers and floor joists
The kind of thing an inspector is looking at under a floor: brick piers and dwarf walls carrying the bearers, joists and everything above them. Site Inspections photograph from our own files, illustrative of the type of work described. It is not a photograph of the property in this case.

The inspector was right. The owners were right to stop paying. It took them from 2018 to 2026 and an appellate court to be told so, and the only reason they could prove any of it is that somebody independent went and looked while the frames were still open.

08What the owners lost, and why it stings

They did not win everything, and the way they lost is instructive.

The owners cross-appealed on two grounds. On the second, the refund of the cash, they succeeded and recovered $50,000 with interest. On the first, they argued the Tribunal had wrongly found that the builder, rather than the owners, validly terminated the contract. That ground never got a hearing on its merits.

Appeals from VCAT to the Court of Appeal run under section 148 of the Victorian Civil and Administrative Tribunal Act, and they are available only on a question of law. The Court held the termination ground was not one:

A.M.O. Rifat Holdings Pty Ltd v Dib[2026] VSCA 124, CATCHWORDS
“Proposed ground alleging error in Tribunal’s findings concerning termination of contract was not on a question of law”, and therefore “No jurisdiction to entertain that ground of proposed cross-appeal”.
The two catchword phrases are quoted separately rather than altering the Court's punctuation. Not dismissed. No jurisdiction to consider it at all.

This matters to anyone contemplating a building dispute. A finding of fact made by the Tribunal, however strongly you disagree with it, is generally the end of the road. The appeal route exists for errors of law. Which means the evidence you put before the Tribunal the first time is very close to your only chance to establish what was actually built, and how badly. That is an argument for having the evidence gathered properly and early, not after a decision has gone against you.

09What this means if you are building right now

Six things, drawn from the judgment rather than from us.

Take this from it
Because
1
Do not agree to pay part of the price in cash
Held void under s 40(2), and the builder was ordered to repay it. It is not a discount, it is an arrangement a court will unwind
2
Opting out of the standard stages changes the schedule, not the protection
s 40(4) substitutes a different table. It does not open the door to side arrangements
3
A stage payment is earned on completion, and completion is a real test
Defective structural brickwork meant the base stage was not complete, and neither were the frames above it
4
Get each stage looked at before you release the money
A defect low in the build travels upward. The cheapest moment to find it is before it is built on
5
If your builder resists an independent inspection, note it
This builder put the owners' proposal to obtain an expert report in a termination notice as a particular of breach
6
Get your evidence right the first time
Appeals from VCAT lie only on a question of law. Findings of fact are usually final, and the builder was refused a second run at his own evidence

One more thing while the build is still running. In Victoria the free remedy for non-compliant work during construction is a Direction to Fix, which costs you nothing and expires at the occupancy permit. And before any of this, it is worth taking two minutes to check the register before you sign.

This case was decided under Victorian legislation in a Victorian court. Every state has its own domestic building legislation and its own limits on what a builder may demand and when. The principles about completion and evidence travel. The section numbers do not.

Get each stage inspected before you release the payment
Site Inspections is an independent building consultancy. We inspect, document and report; we do not carry out rectification work, and we have no interest in the outcome of any claim.
Request a construction stage inspection
Every job is quoted. Or contact us to talk it through first.

10Sources

Every quotation on this page is taken from the judgment itself, read in full on 15 August 2026.

1.
A.M.O. Rifat Holdings Pty Ltd v Dib [2026] VSCA 124
Supreme Court of Victoria, Court of Appeal. Niall CJ, Beach and Donaghue JJA. Heard 25 March 2026, judgment 4 June 2026. On appeal from A.M.O. Rifat Holdings Pty Ltd v Dib (Building and Property) [2024] VCAT 419 (Woodward P). The source for the contract and side agreement, the quoted conversation, the stage table, the base stage and frame stage findings, the quantum meruit reasoning, the s 40(2) holding, the termination notice particulars, the jurisdiction ruling and the orders.
2.
Domestic Building Contracts Act 1995 (Vic)
Sections 3(1), 40(1), 40(2), 40(4), 53(1), 53(2)(b)(iii) and 132(1), as quoted and applied in the judgment.
3.
Victorian Civil and Administrative Tribunal Act 1998 (Vic), section 148
The appeal right relied on, available only on a question of law, and the basis on which the Court held it had no jurisdiction over the owners' first cross-appeal ground.
4.
Authorities applied and considered in the judgment
Stephens v Cameron (2021) 65 VR 117, applied. Mann v Paterson Constructions Pty Ltd (2019) 267 CLR 560, Pavey & Matthews Pty Ltd v Paul (1987) 162 CLR 221 and South Australian Harbors Board v South Australian Gas Co (1934) 51 CLR 485, considered. Cardona v Brown (2012) 35 VR 538, cited on the effect of an incomplete stage. Imerva Corporation Pty Ltd v Kuna [2017] VSCA 168, distinguished.
